Town of Canandaigua
North Road Reconstruction and Sidewalks

Questions

If you have any questions, please contact us!

About the Project

This project focuses on the comprehensive reconstruction of North Road, spanning from the intersection of CR 28 to East Avenue (approximately 4,600 linear feet), along with the resurfacing of an additional 350 linear feet to the intersection of Sand Hill Road.

​

Key enhancements include shifting travel lanes north by 3 to 4 feet, the installation of mountable curbs, and the addition of a multi-use concrete trail on the south side of the road. The updated highway design will feature two 11-foot wide travel lanes, two 2-foot wide shoulders, mountable curbs, and an eight-foot wide sidewalk.

​

Significant improvements involve a new underdrain system, a storm sewer system, and the rehab of a major cross culvert near Cayuga Road with a structural spray-on liner.



Additional enhancements include a sidewalk extension along the west side of East Street, connecting to the existing pathway leading to Canandaigua Academy High School.​This initiative aims to ensure safe access to the school by linking the existing sidewalk near Tim Horton’s along North Road to the school entrance on East Avenue.

ScreenHunter 462.png
About The Project
Why Now

Why Now?

  • Need for Multi-Modal Transportation: Previous town studies and plans have identified a significant lack of multi-modal transportation options along the existing road.

​

  • Traffic Demands: The current volume and weight of traffic on North Road necessitate a more robust pavement section, as the northern lane is experiencing ruts and deterioration.

​

  • Aging Drainage System: The existing drainage system is beyond its useful life and is ineffective at properly draining the road base, leading to widespread alligator cracking.

​

  • Ongoing Repairs: Frequent water main breaks have resulted in numerous pavement patches, contributing to the road’s overall deterioration.

​

  • Long-Term Planning: This project has been in consideration for nearly a decade, awaiting the completion of the water main replacement, which has now been successfully finished.

When

When?

  • Project was put out for public bid April 16, 2025

​

  • Bid opened on May 14, 2025

​

  • Bid awarded to Nardozzi Paving and Construction on May 28, 2025

​

  • ​Construction Start: Anticipate July 23, 2025

​

  • ​Estimated Duration: The project is expected to take approximately 15 to 17 months to complete.

Cost

How Much Will It Cost?

  • Estimated Cost: The project is currently estimated at approximately $6.5 million.

​

  • Financing Duration: Financing is anticipated to span over 15 years.

​

  • Budget Considerations: Principal and interest (P&I) are already factored into the budget.​

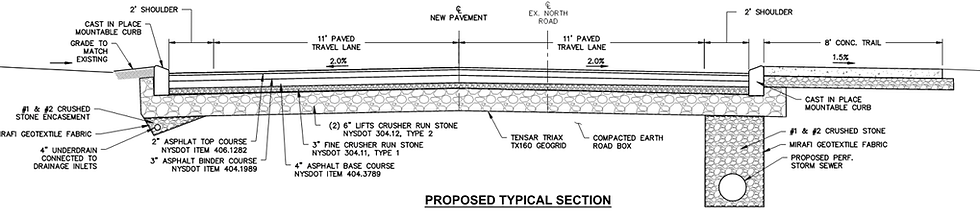

Proposed Typical Section
